Hopland 101 Project

Caltrans proposes to construct improvements on U.S. Highway 101 in downtown Hopland in Mendocino County (post miles 10.7 and 11.2) for compliance with the Americans for Disabilities Act (ADA). Work would include improving curb ramps, sidewalks, and driveways, reconstructing the roadway, rehabilitating pavement, and signage.

The purpose of the proposed project is to improve the safety and accessibility of pedestrian facilities in downtown Hopland in conformance with the ADA, and to improve, pavement, and signage.

Construction Update

Phase 4A (August 23-27)

Work includes roadway excavation and repaving. (Mountain House Road, Route 175 Intersection, Center Street, First Street).

Street Closures/Access

Center Street (East)
First Street (West)
Private driveways will remain open, except when access is temporarily affected by active intersection construction.

Parking

Street parking is available along northbound U.S. 101 between Route 175 and Center Street. Additional parking is available near the Great Redwood Trail Agency parking area, accessible from Route 175 or the east side of First Street.

Phase 4B (August 30-September 3)

Work includes roadway excavation and repaving. (Mountain House Road, Route 175 Intersection, Center Street, First Street).

Street Closures/Access

Center Street (West)
First Street (East)
Private driveways will remain open, except when access is temporarily affected by active intersection construction.

Parking

Street parking is available along northbound U.S. 101
Additional parking will be available near the Great Redwood Trail Agency parking area, accessible from Center Street.

Traffic Delays

Motorists traveling in Hopland between the Feliz Creek Bridge and north of First Street should anticipate up to 15-minute delays during overnight hours from 8 p.m. to 6 a.m., Sunday through Thursday. Expect delays at Mountain House Road and at Route 175. Posted speed limits will be reduced to 25 mph during construction and motorists are asked to drive with caution in the work zone.
The project will operate on a continuous schedule, running 24 hours a day from Sunday at 8 a.m. through Friday at 7 a.m. This approach is designed to minimize the overall project timeline and enhance safety for both workers and the public.

Parking and Access

All businesses are open during construction. Temporary impacts to parking and access may occur within the work area, but measures will be taken to limit disruptions.

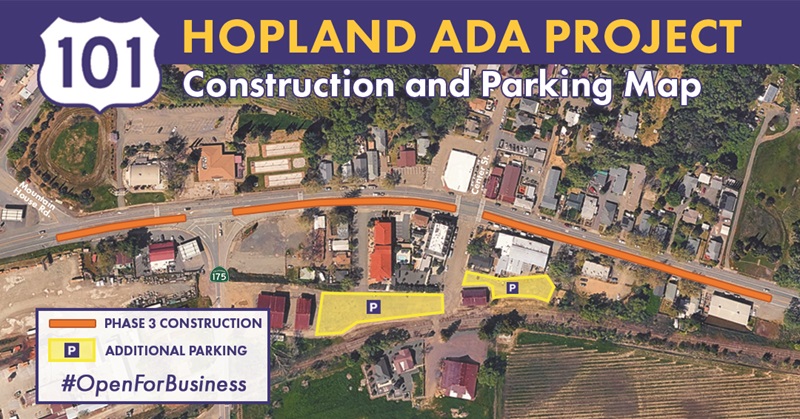

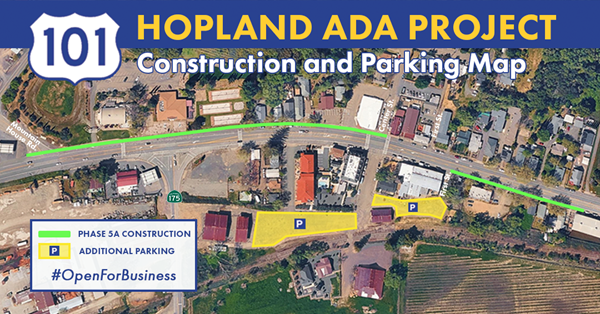

Hopland ADA Construction and Parking Map shows three areas of construction in downtown Hopland. Two parking lots are highlighted in yellow behind a row of buildings.

Project Schedule

  • PG&E utility relocations and broadband installation – complete
  • ADA project start – July 12, 2026
  • Construction complete – November 2026

Budget

  • Roadway and construction: $11,187,000
  • Right-of-Way: $804,000

Simulation of proposed ADA improvements to U.S. 101 in Hopland, Mendocino County.

Rendering of proposed ADA improvements to U.S. 101 in Hopland

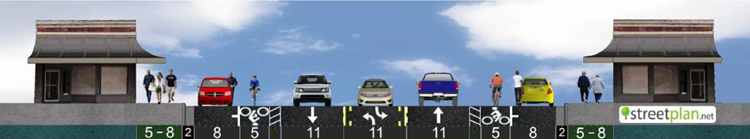

Rendering of 5 to 8 foot sidewalks, 8 foot parking lanes, 5 foot bike lanes and 11 foot driving and turning lanes for the Hopland 101 project in Mendocino County.

Rendering of sidewalks, parking lanes, bike lanes and driving lanes.

Documents

Accessibility Assistance: Caltrans makes every attempt to ensure our documents are accessible. Due to variances between assistive technologies, there may be portions of this document which are not accessible. Where documents cannot be made accessible, we are committed to providing alternative access to the content. Should you need additional assistance, please contact us at (916) 654-2852 or visit https://dot.ca.gov/request-ada-compliant-documents.

How to get involved

Monthly project updates are provided at Hopland Municipal Advisory Committee (HMAC) meetings. For meeting information, please visit the HMAC website.
Follow Caltrans District 1 on Facebook, and Instagram.

Call (707) 994-9362 for project information and comments.

Contacts

Project Manager: Marie Brady

Media Inquiries: Manny Machado, (707) 496-6879, TTY 711

Email: HoplandADA@dot.ca.gov

Last reviewed: August 2026

Hopland ADA Project Winter Update 2024-2025

Hopland ADA Project Community Meeting | April 12, 2022

Hopland Construction Photos

A construction crew of about 9 wearing yellow high visibility gear smooth freshly poured concrete on US 101 in Hopland.

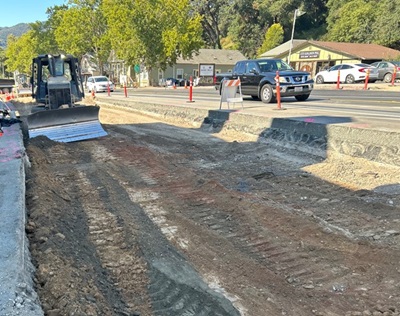

Heavy equipment grades a demolished lane of US 101 in Hopland as one-lane traffic continues to flow next to the work area.

August 2026

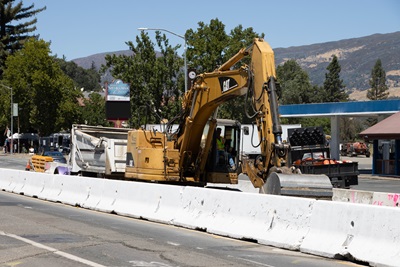

An excavator works along US101 in Hopland.

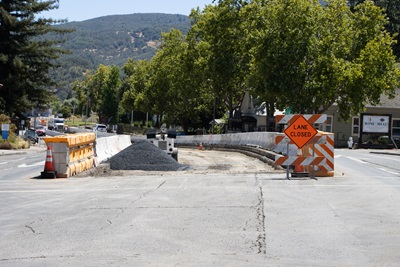

Construction on US101 in Hopland. The center lane is being resurfaced.

Sign reading "Businesses Open" placed along US101 in Hopland

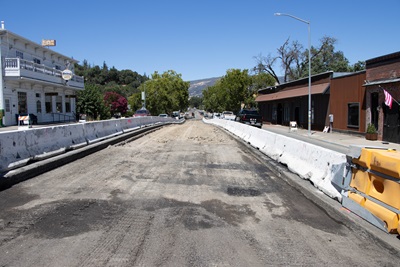

Construction on US101 in Hopland. the center lane is torn out and traffic continues to flow.
